Building for the Future
Construction Progress
Follow the rebuild of Masjid Al-Hikmah — from groundworks to grand opening.
Milestones Complete
31% of project complete
Currently Underway
Phase 1 Open for Use
ActiveNext Milestone
Phase 2 Commencement
April 2026
Grand Opening
Late January 2027
Grand Opening
March 2025
Commencement of Works
New contractors appointed and plans revised.
March 2025

Commencement of Works
New contractors appointed and plans revised.
September 2025
Corrective Works Complete
Corrective works from previous contractors and teams.
September 2025

Corrective Works Complete
Corrective works from previous contractors and teams.
October 2025
First Fix Complete
Plumbing, Electrical, Plant Room, Whudu Area & W/C's
October 2025

First Fix Complete
Plumbing, Electrical, Plant Room, Whudu Area & W/C's
February 2026
Second Fix Complete
Tiling, Fixtures & Fittings, Doors, Windows, Carpets

February 2026
Second Fix Complete
Tiling, Fixtures & Fittings, Doors, Windows, Carpets
March 2026
Phase 1 Open for Use
Building to be used for Madrassah.
March 2026

Phase 1 Open for Use
Building to be used for Madrassah.
April 2026
Phase 2 Commencement
Finalisation of Phase 2 Plans.
April 2026

Phase 2 Commencement
Finalisation of Phase 2 Plans.
May 2026
Deconstruction
The main building will be completely deconstructed, leaving only the front facade remaining.
May 2026

Deconstruction
The main building will be completely deconstructed, leaving only the front facade remaining.
July 2026
Groundworks & Foundations
Excavation, concrete foundations and drainage installed.
July 2026

Groundworks & Foundations
Excavation, concrete foundations and drainage installed.
August 2026

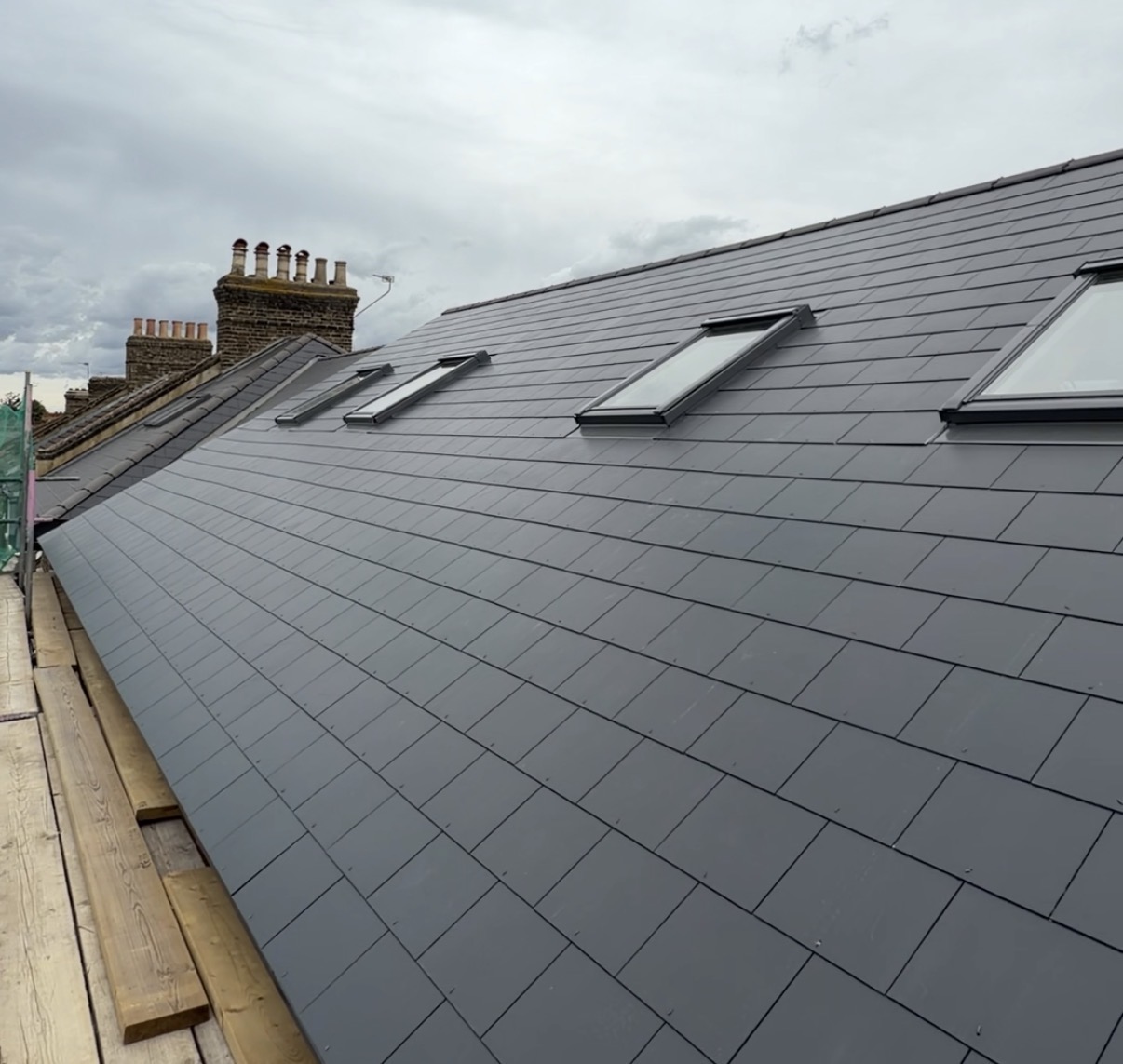

Structural Works
Steel frame and masonry walls erected, roof structure completed.
August 2026
Structural Works
Steel frame and masonry walls erected, roof structure completed.
November 2026
First Fix
Electrical, plumbing and heating services run through the structure.
November 2026
First Fix
Electrical, plumbing and heating services run through the structure.
December 2026
Second Fix
Sockets, switches, sanitaryware, doors and plastering completed.
December 2026
Second Fix
Sockets, switches, sanitaryware, doors and plastering completed.
January 2027
Fit Out & Finishing
Prayer hall carpets, mihrab, minbar, sound system, lighting and final finishes installed.
January 2027
Fit Out & Finishing
Prayer hall carpets, mihrab, minbar, sound system, lighting and final finishes installed.
Late January 2027
Grand Opening
Masjid Al-Hikmah opens its doors — just in time for Ramadan 2027.
Late January 2027
Grand Opening
Masjid Al-Hikmah opens its doors — just in time for Ramadan 2027.
